Resolve complexity and uncertainty with continuous and fast feedback to create ability responding to changes with low cost, so that achieve better effect
Scrum is an agile process that allows us to focus on delivering the highest business value in the shortest time……It is iterative and incremental…… (from Mike Cohn)
Open mind, active exploring, willing to share and help others. Experienced in transformation or at least understand political ego-system of organization, be good at using power w/o eager to that. Above average level of technology and product knowledge. Have communication and influencing skill. More of extroversion.
Scrum Master Common Focused Area ScrumMaster常见的关注领域
Team
Ceremonies & Meetings Facilitation 引导仪式和会议
Learning & Team Development 学习和团队发展
PO
PB Refinement 需求待办清单的梳理
Tech
Continuous Integration 持续集成
Decoupling 解耦
Organizational
Cross-team collaboration 跨团队协作
Coaching upper management 对管理层进行教练
Increase Transparency 提高透明性
Scrum的3个工件
Product Backlog 产品Backlog
An ordered and emerginglist of features fulfilling the Product Vision
一份动态的有序列表,包含了符合产品愿景的各种功能
And other things providing value to the user
以及其他为用户带来价值的工作
A healthy product backlog must be “UPERFORM”:
一个健康的product backlog应当满足UPERFORM原则:
Unified, 唯一的
Pull-based, 拉动式
Emergent, 动态的
Revealed, 公开的
Feature-sliced, 纵切的
Ordered, 已排序
Refining, 持续精炼
Measurable, 可度量
Open to all but ultimately groomed by the PO; 对所有人开放但最终由PO维护
Focus on ‘WHAT’ brings users the biggest value; 关注于“什么“带给用户最大的价值
The best Product Owner starts with “WHY”; 最优秀的PO从“为什么”开始
Sprint Backlog 迭代待办项列表
The Product Backlog items selected for this Sprint plus the plan for delivering them 为本Sprint所选择的PBI以及交付所选PBI的工作计划之和
Extension and subset of the product backlog
产品Backlog 的延伸和子集
The set of work to achieve the Sprint Goal 为实现Sprint目标所要完成的工作集合
JIT (Just In Time) design in considered
涵盖‘恰到好处’的设计
Breaks large work down into smaller pieces (PBI -> SBI)
将大块的工作分解为更小的单元 (PBI -> SBI)
Focuses on ‘HOW’ team is going to get the work done and deliver the value in one sprint
关注于“怎么做”的问题:如何在一个sprint内完成工作以交付价值
Owned by the Development Team
被开发团队拥有
Team selects items from the product backlog they can commit to completing and creates the sprint backlog
团队从product backlog中选取他们可以承诺完成的项目并创建sprint backlog
Collaboratively, not done alone by the ScrumMaster
协作完成,不是由ScrumMaster负责
A visible tool for the team to manage itself during the sprint
一个可视化的工具让团队在sprint内部自我管理
Sprint Goal 迭代目标
The Sprint Goal is an objective set for the Sprint that can be met through the implementation of Product Backlog. 迭代目标是本迭代中通过实现PB来达成的目标
It provides guidance to the Development Team on why it is building the Increment. 向团队提供构建该增量的理由(why)
It is created during the Sprint Planning meeting. 在Sprint Planning会议上产生
The Sprint Goal gives the Development Team some flexibility regarding the functionality implemented within the Sprint. 给予团队一些在功能实现上的灵活性
Visible Task Board Kanban 可视化任务墙看板
Task board is a common visible tool to manage sprint backlog 任务板是一个常见的用于管理sprint backlog的可视化工具
Self-organized: Individuals or small groups sign up for work 自组织:团队成员或小分队自己领取工作
Team decomposes PBI to SBI 团队一起将PBI分解为SBI
Team decides SBI granularity 团队决定合适的SBI颗粒度
Work is not assigned 没有一个人主导任务的分配
Sign up for new work after one work is done 完成一项任务才认领另外一项任务
Based on priority and try to reach fully DONE on a PBI 按照优先级,努力使一个PBI尽早完全完成
Team tracks remaining work of the Sprint, daily
团队每天跟踪Sprint中剩余的工作
Any team member can add, delete or change the sprint backlog item (SBI)
任何团队成员可以添加,删除或变更sprint backlog事项 (SBI)
Work for the sprint may emerge
sprint内的工作有可能动态涌现
Visible to the world,对全世界可见
Update in real time,随时更新
Represents the current progress toward the Sprint Goal,
直观展示Sprint目标完成的进展
Work visibility management tool, 工作可视化管理的工具
Sprint Burn Down Charts 迭代燃尽图
Sprint Burn Down Charts Sprint 燃尽图是一个可选的可视化工件,用来管理Sprint Backlog,并帮助团队自己跟踪进度和暴露风险
Updated in real time 随时更新
Represent the amount of work remaining,度量Sprint剩余工作的总量
Different approaches to creating burndown charts,燃尽图有不同思路
The sum of all the Product Backlog items completed during a Sprint and the value of increments of all previous Sprints
当前Sprint所完成的PBI,以及之前所有Sprint的增量价值之和
Potentially releasable and meet the Definition of Done
潜在可交付,并符合完成的定义
Must be in useable condition regardless whether the Product Owner decides to release it
必须是可用的产品,不管PO是否决定对外发布

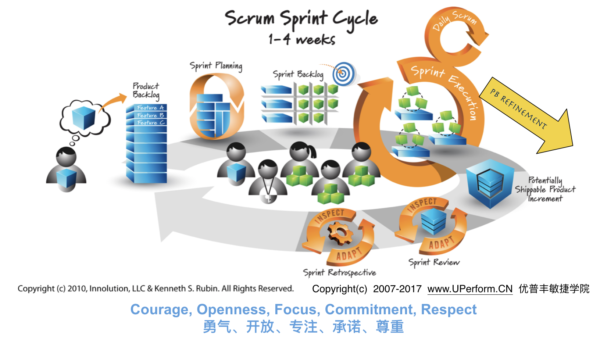

Scrum的5个事件
Sprint 迭代
Scrum projects make progress in a series of “sprints”
Scrum项目由一系列“sprint”组成
Analogous to Extreme Programming iterations
借鉴了极限编程中的“迭代”
Typical duration is less than a calendar month at most, or even shorter
不超过一个月的日历时间, 建议1~2周
A constant duration leads to a better rhythm
通常是定长的,有利于产生更好的交付节奏
Sprint ends only when the time-box expires
只有当时间盒到期时,Sprint结束
Product is developed according to DoD within a Sprint
根据DoD定义,全部相关工作在sprint内完成
Not to change Sprint Goal; 不去改变Sprint的目标
Not to change Sprint length during a Sprint; 不改变当前运行中的Sprint的长度
Can a Sprint be terminated?
Sprint可以被中止吗?
Yes 可以
Product Owner can cancel the Sprint if business circumstances require
出于业务需要,Product Owner可以取消Sprint
Team can discuss with Product Owner to see how to handle, if they are unable to accomplish anything
如果无法完成任何东西,团队可以和PO协商应对
Go back to Sprint planning — any “not done” work performed should be put back to Product Backlog
重新做Sprint计划-所有还”未完成的工作”放回产品Backlog
Very rarely done! 罕有发生!
Sprint Planning 迭代计划会
Timebox: max 8 hours for 1 month Sprint
时间盒:1个月的Sprint最长8小时
Part I SELECTION 第一部分 选择
Define the Sprint Goal 定义迭代目标
Select the Product Backlog Items the team can commit to complete 选择团队可以承诺完成的迭代待办项
Part II PLANNING 第二部分 计划
Decide how to achieve the Sprint Goal 决定如何实现迭代目标
Create the Sprint Backlog 创建 Sprint Backlog
Estimate the Sprint Backlog Items 估算迭代待办项
Part I
参与者: Product Owner/Development Team/[ScrumMaster]
输入: Healthy Product Backlog 健康的产品Backlog
输入: Latest Increment 最新版本的增量
输入: Velocity of the Development Team of this Sprint 团队这个Sprint的速率
输出: Crafts a Sprint Goal with Selected Product Backlog Items 根据所选择的产品Backlog事项制定Sprint目标
Part II
参与者: Development Team/[Product Owner]/[ScrumMaster]
输入:Capacity of everybody of this Sprint 团队这个Sprint所有人的工作容量
输出: Plan on how to meet the Sprint Goal (Sprint Backlog) 如何实现Sprint目标的工作计划(Sprint Backlog)
输出: Mutual agreement on the Sprint Goal 大家对Sprint目标形成共识
Daily Scrum 每日站会
Parameters,参数
Daily,每日
Same time same place, 同一时间同一地点
15-minutes,15分钟
Stand-up,站立
参与者: Development Team, [ScrumMaster], [Product Owner]
Inspect & adapt on Sprint progress for Sprint Goal, 为达致Sprint目标检视进展和调整计划
Not for specific problem discussion and solving,不讨论和解决具体问题
Other people can be invited to observe,其他人可以受邀来旁听
Only team members, ScrumMaster, Product Owner, can talk
只有团队成员,ScrumMaster和Product Owner可以说话
Helps avoid other unnecessary meetings
帮助避免其他不必要的会议
每个人回答三个问题
What did I get DONE yesterday to help DT meet Sprint Goal? 昨天我完成了什么,以便帮助交付团队达成迭代目标?
What will I get DONE today to help DT meet Sprint Goal? 今天我要完成什么,以便帮助交付团队达成迭代目标?
Are there any impediments slowing/blocking my progress to meet Sprint Goal? 有什么障碍影响我的进度和迭代目标吗?
This is NOT status for the ScrumMaster, it is broadcast in front of peers for self-management 不是向ScrumMaster汇报状态,而是向所有组员的广播,属于自管理的一部分
Sprint Review 迭代评审会
Inspect & adapt on the Product and Product Backlog 检视和调整产品和产品Backlog
Team presents what it accomplished in the sprint that PO should accept timely 团队展示Sprint的成果,PO应当尽早验收
Product Owner explains what have been accepted as “Done” work and what have been rejected as “ not done” work 产品负责人表明哪些“完成”的工作被接受了,哪些“未完成”的工作被退回了
Typically takes the form of a demo of new features or underlying architecture, obtain feedback and discuss on future adjustment to optimize value
经常以Demo新功能(及其依赖的架构)的形式,获取反馈和讨论接下来要做的工作,从而持续优化价值
Informal,非正式
4 hours max time-box for 1 month Sprint 1个月的Sprint时间盒最长4小时
No slides 不要用幻灯片
Least Preparation 尽量不要准备
Whole Scrum team participates
全Scrum团队参与
Invite all stakeholders and interested parties
邀请所有干系人及感兴趣的人士
Sprint Retrospective 迭代回顾会
Inspect & adapt on how we work (people, relationships, process, tools…)
对我们如何工作(人、关系、过程、工具等)进行检视和调整
Continuous improvement on process, 对过程的持续改进
Timebox: 45min for 1 week Sprint 时间盒:每1周的Sprint花费45min
Whole Scrum team participates,全Scrum团队参与
Other interested parties are welcome by invitation,欢迎其他感兴趣的受邀人士
In a safe environment,在安全的环境中进行
One popular format: 3 Question format,一个流行的形式:三个问题
Start doing,开始做什么?
Stop doing,停止做什么?
Keep doing,继续做什么?
输出: Improvement Action Plan for next Sprint 下一个Sprint的改进行动计划
